Costs & planning

How Long Does a Bathroom Remodel Take?

Most bathroom remodels take 2 to 6 weeks of work in your home. Here is the timeline by project, what happens in each phase, and what adds time.

Yevgeniy Shestopal · Chief Executive Officer, Western RenovationsPublished 5 min read

Bathroom remodel near completion with new white tile, a tiled shower and oak vanity, with painter’s tape and floor protection still in place

Key takeaways

  • Most full bathroom remodels take 2 to 6 weeks of work in your home.
  • A tub-to-shower conversion or an accessible upgrade often takes 2 to 4 weeks. Primary bathrooms take 3 to 6 weeks, and up to 8 for a large room or a spa suite.
  • The clock on site starts after design, ordering and permits. Those come first and vary by project and by city.
  • Layout changes, tile, custom glass, repairs behind the walls and change orders add the most time.

How long does a bathroom remodel take?

Most bathroom remodels take 2 to 6 weeks of work in your home. A small bathroom is at the short end. A primary bathroom with layout changes is at the long end, and can run to 8 weeks.

That is time on site, from the first day of tear-out to the final walkthrough. Design, ordering materials and the permit come before it. This page covers both parts.

These are ranges from our own projects over the last 12 months, not promises. Every home is different, and you get a schedule for yours before work starts.

Bathroom remodel timeline by project

ProjectTypical time on site
Grab bars and a comfort-height toilet2 – 3 days
Powder room3 – 7 days
Small bathroom or guest and hall bath1 – 2 weeks
Tub-to-shower conversion2 – 4 weeks
Accessible full bathroom2 – 4 weeks
Full bathroom remodel2 – 6 weeks
Primary bathroom3 – 6 weeks
Large primary or spa suite4 – 8 weeks

The phases of a bathroom remodel, in order

Before work starts: visit, quote, selections and permit

It begins with a free in-home visit. We measure, check the plumbing and talk about how you use the room. Then you get a written, itemized quote.

Once you approve it, you pick your tile, vanity, glass and fixtures. We order materials and apply for the permit. Work is scheduled when the permit is issued and the long-lead items have dates.

How soon work starts after you approve the quote depends on our availability, the permit and your materials. We give you a start date before you sign.

1. Protection and tear-out

We protect your floors and the path to the bathroom. Then the old tub, tile, vanity and fixtures come out. This is the loudest and dustiest part, and it is short.

Once the walls and floor are open, we can see the framing, the subfloor and the plumbing. If something needs repair, this is when we find it.

Typical time: 1 to 2 days.

2. Rough plumbing and electrical

Drains, supply lines and the shower valve are set in their new positions. Electrical for lighting, the fan and outlets goes in. If walls are moving or a doorway is getting wider, framing happens here too.

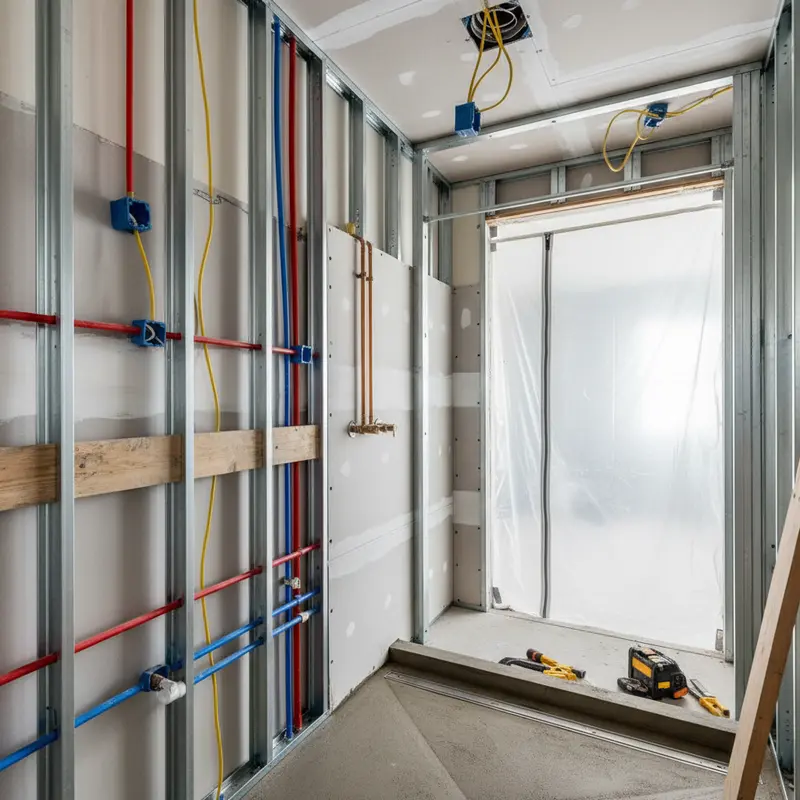

Bathroom at the rough-in stage with open stud walls, new PEX water lines, a shower valve and electrical boxes

Then the inspector checks the work before the walls are closed. Waiting for that visit can add a day or two.

Typical time: 3 to 5 days. The rough inspection is usually scheduled 2 to 5 days out.

3. Walls, shower pan and waterproofing

Backer board goes up. The shower floor is built and sloped to the drain, or a prefab base is set. Every wall in the wet area gets a waterproof layer.

This step has waiting built in. Mortar and waterproofing need time to cure before tile goes on. Rushing it is how showers leak.

Typical time: 2 to 4 days, including cure time.

4. Tile, or panels

Tile is usually the longest single phase. Floor tile, wall tile, niches and a bench are set, then grouted and sealed. Small mosaics and detailed patterns take longer than large tile.

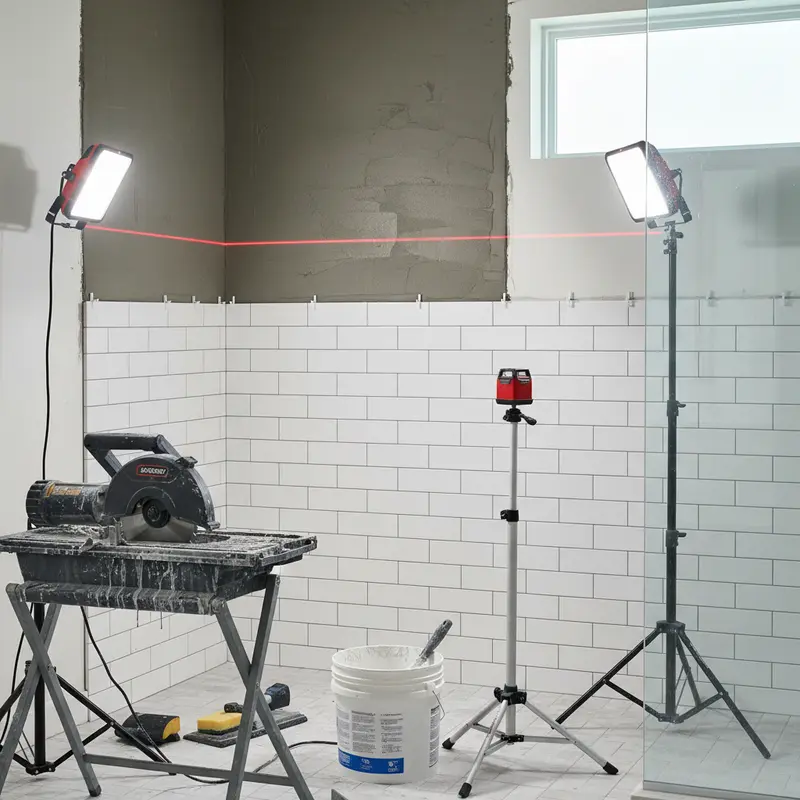

Shower wall being tiled with large porcelain tiles over waterproofing membrane, with a trowel and thinset bucket on the floor

Prefab wall panels go up much faster. That is one reason a prefab shower finishes sooner than a tiled one.

Typical time: 3 to 7 days for tile.

5. Vanity, counters, fixtures and paint

The vanity and countertop go in. Then the toilet, faucets, shower trim, lighting, mirrors and accessories. Walls are painted and trim is finished.

Typical time: 2 to 4 days.

6. Glass, final inspection and walkthrough

Custom shower glass is measured after the tile is set, then made for your exact opening. That is why glass goes in near the end.

After the final inspection, we walk through the bathroom with you. We check every fixture, grout line and drain together and show you how to care for everything.

Typical time: 1 day to measure and 1 day to install. The wait in between, while the glass is cut to size, varies.

What adds time to a bathroom remodel

  • Layout changes. Moving a drain, a wall or a doorway adds framing, plumbing and inspection steps.
  • Tile and custom glass. Tile takes longer than panels. Frameless glass is made to order after the tile is in.
  • Special-order materials. A custom vanity or a tile that is out of stock can hold up the start.
  • The permit office. Your address decides who issues the permit. Roseville, the City of Sacramento, Sacramento County and Placer County each have their own process and pace.
  • What is behind the walls. Old water damage or worn-out plumbing has to be fixed before anything new goes in.
  • Change orders. Changing the tile or the layout after work starts means new materials and new steps. We put every change in writing for your approval first.

Why a one-day bathroom is a different product

You may have seen offers for a new shower or tub in one day. Those are liner and wall systems made to fit over or into the existing space, so the work behind the walls is kept to a minimum.

A remodel opens the walls, updates the plumbing and rebuilds the waterproofing. The steps above take days each, and some of them need time to cure. That is true for our acrylic panel showers as well as our tiled ones. We do not offer one-day installs.

How to keep your remodel on schedule

  • Make your selections before work starts, and stick with them.
  • Choose in-stock materials when the schedule matters most.
  • Keep the layout if you can.
  • Decide quickly when we ask a question on site.
  • Plan for the bathroom you will use in the meantime.

Our process page shows each step from the first visit to the final walkthrough. For pricing, see the bathroom remodel cost guide. When you are ready for a schedule for your own bathroom, get a free estimate.

The Bottom Line

Most bathroom remodels take 2 to 6 weeks of work in your home, and primary bathrooms can take up to 8. Design, ordering and the permit come first. Layout changes, tile, custom glass, hidden repairs and change orders add the most time. You get a schedule for your project before work starts.

Sources

  1. Western Renovations service timelines · Western Renovations

Frequently Asked Questions

Still have a question?

Talk to a real person on our team. We’re happy to help, even if you’re just starting to plan.

How long does a small bathroom remodel take?

A powder room usually takes 3 to 7 days. A small full bathroom or a guest and hall bath usually takes 1 to 2 weeks of work in your home. Tile and custom glass add time. You get the schedule before work starts.

How long does a primary bathroom remodel take?

Most primary bathrooms take 3 to 6 weeks on site. A large primary or a spa suite with layout changes can take 4 to 8 weeks. Moving plumbing, a freestanding tub and a large tiled shower are the usual reasons for the longer end.

Can I stay in my home during the remodel?

Yes. Most clients stay home. If it is your only bathroom, we talk through options during the visit so you can plan ahead.

How long does a bathroom permit take?

It depends on the city or county and on the work. Simple like-for-like remodels are often permitted faster than jobs that need a plan review. We take care of the permits and inspections, and we build the wait into your schedule.

Why does shower glass go in last?

Frameless glass is measured after the tile is finished, so it fits your exact opening. Then it is made to order. The shower cannot be used until the glass is in and the sealant has set.
