Bathroom remodeling was the number-one most common remodeling project in 2025, with 73% of remodelers rating it common to very common (NAHB Remodeling Market Index, Q4 2025). Yet 58% of homeowners say renovations consistently exceed their time expectations (Clever Real Estate, 2024). That gap between expectation and reality is where frustration lives — and it's almost always preventable.

We've completed over 358 bathroom projects across Roseville, Sacramento, Folsom, and the surrounding area. This guide breaks down exactly how long each phase takes, what Sacramento-specific factors affect your timeline, how to handle permits in Placer and Sacramento counties, and the most effective strategies we've found for keeping projects on schedule. Whether you're planning a quick guest bath refresh or a full master suite renovation, you'll know what to expect before demo day.

TL;DR: Most Sacramento bathroom remodels take 3-8 weeks of active construction, but the total project timeline — including design, permits, and material ordering — runs 2-5 months. Guest baths average 3-5 weeks of construction; master suites run 5-8 weeks. Sacramento County permits take 2-6 weeks. The biggest delays come from material lead times (custom vanities need 6-12 weeks) and hidden damage discovered during demo. Book contractors early — the construction industry faces a 439,000-worker shortage nationally (ABC, 2025).

How Long Does a Bathroom Remodel Actually Take?

The honest answer: longer than most homeowners expect. According to a 2024 Clever Real Estate survey, 54% of homeowners believed their renovation would take one month or less — but only 48% actually finished in that timeframe. Here's what the construction timeline actually looks like by project type.

Timeline by Bathroom Type

  • Half bath or powder room refresh: 1-2 weeks of construction. This covers a vanity swap, new mirror, updated lighting, fresh paint, and possibly new flooring. No plumbing relocation or structural work.
  • Guest or hall bathroom remodel: 3-5 weeks of construction. Includes tub-to-shower conversion or tub replacement, new tile, vanity, toilet, and fixtures. May involve minor plumbing changes.
  • Master bathroom remodel (moderate scope): 5-8 weeks of construction. Walk-in shower installation, double vanity, new flooring, updated lighting, and ventilation. Plumbing stays in roughly the same locations.
  • Master bathroom full gut renovation: 8-14 weeks of construction. Complete layout change, plumbing relocation, possible wall removal, custom shower, freestanding tub, heated floors, and custom cabinetry.

Construction vs. Total Project Time

Those numbers are construction time only. The total timeline from your first consultation to final walkthrough is typically twice as long. A Houzz study found that homeowners dedicate roughly twice as much time to planning as they do to construction across all room types (Houzz, 2024). For kitchens — which share similar trade work with bathrooms — planning averaged 9.6 months while construction averaged 5.1 months.

Here's a realistic total timeline for each project type:

  • Half bath refresh: 4-8 weeks total (1-3 weeks planning + 1-2 weeks construction)
  • Guest bathroom remodel: 2-3 months total (3-6 weeks planning + 3-5 weeks construction)
  • Master bathroom remodel: 3-5 months total (4-8 weeks planning + 5-8 weeks construction)
  • Full gut renovation: 4-7 months total (6-12 weeks planning + 8-14 weeks construction)

For a detailed cost breakdown by project scope, see our Sacramento bathroom remodel cost guide for 2026.

What Happens Before Construction Starts?

Bathroom remodel design planning materials including blueprints tile samples and 3D rendering on a consultation table

The pre-construction phase is where most homeowners lose time they didn't expect to spend. But it's also where you prevent the delays, budget surprises, and design regrets that derail projects mid-stream. Here's what this phase involves and how long each step takes.

Design Consultation and Planning (2-4 Weeks)

This starts with an in-home consultation where we measure the space, discuss your goals, review your budget, and identify any structural constraints. For Sacramento-area homes — especially the ranch-style and split-level homes built in the 1970s-1990s — we're also checking for outdated galvanized plumbing, polybutylene pipes, and older electrical panels that might need upgrading.

You'll review design options, choose materials, and finalize the layout. We present a fixed-price proposal so there are no surprise costs once construction begins. This typically takes 2-4 meetings over 2-4 weeks.

Material Selection and Ordering (2-6 Weeks)

Material lead times are the hidden timeline killer in bathroom remodeling. Here's what to expect in 2026:

  • In-stock tile: Ships in 2-5 days. Specialty or imported tile can take 3-6 weeks.
  • Stock vanities: Available in 1-2 weeks. Semi-custom vanities: 7-10 business days. Custom vanities: 6-12 weeks.
  • Frameless glass shower doors: 5-10 business days for manufacturing after final measurements (which happen post-tile).
  • Quartz or granite countertops: 2-4 weeks from template to installation.
  • Standard fixtures (toilets, faucets, showerheads): Usually in stock. Specialty finishes (brushed gold, champagne bronze) may require 2-4 weeks.

We order long-lead materials as early as possible to prevent construction delays. If you've chosen a custom vanity with a 10-week lead time, we'll place that order during the design phase so it arrives before or during construction.

Permits and Inspections (2-6 Weeks)

Most bathroom remodels in Sacramento, Roseville, and Placer County require a building permit — especially if you're changing plumbing layout, electrical wiring, or structural elements. We handle the permit application process, but the processing time is up to the local building department. More on Sacramento-specific permits in the section below.

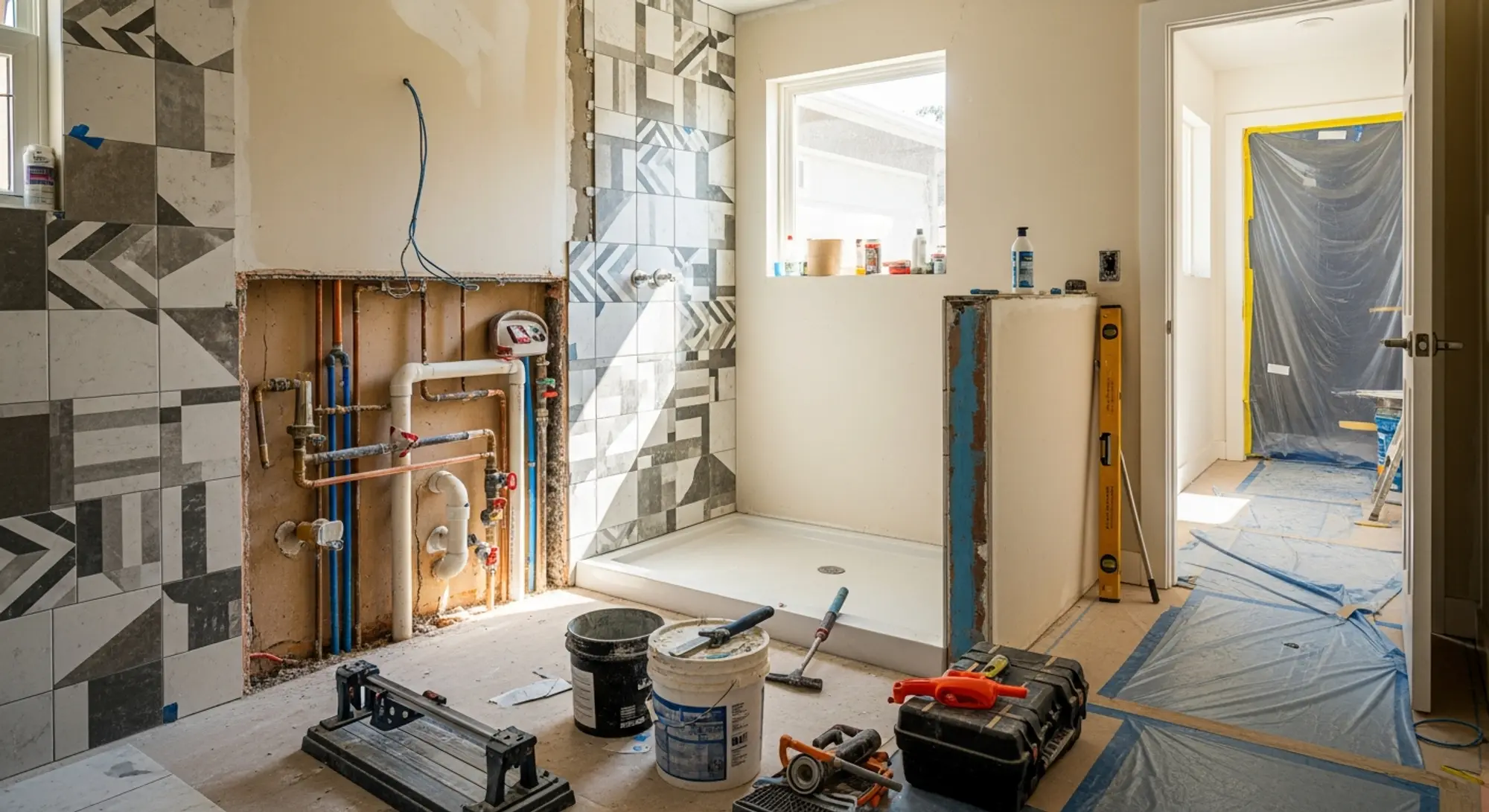

What Does a Week-by-Week Bathroom Remodel Schedule Look Like?

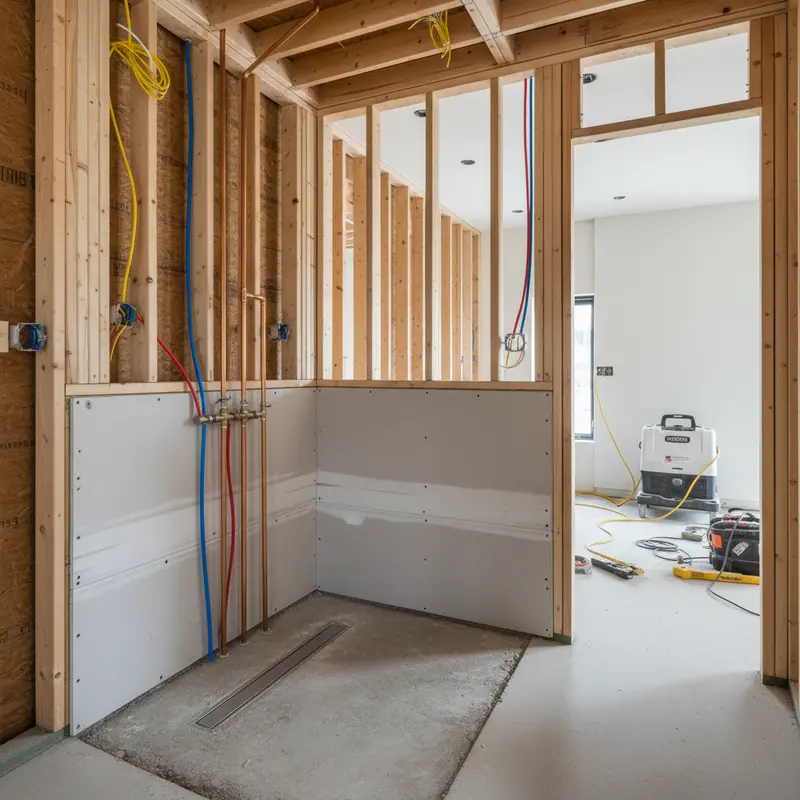

Bathroom rough-in phase showing new plumbing pipes electrical wiring and cement backer board installation

Here's the construction phase broken down for a typical guest or master bathroom remodel. Times overlap in some phases because different trades can work simultaneously.

Days 1-2: Demolition

Demolition is fast. We remove the old tub or shower, vanity, toilet, flooring, and drywall as needed. For a standard bathroom, demo takes 1-2 days. We protect your home with plastic sheeting and use HEPA filtration to control dust — especially important in pre-1980s Sacramento homes where lead paint or asbestos may be present.

This is also when we discover any hidden issues: water damage behind walls, outdated wiring, corroded pipes, or subfloor rot. Industry estimates suggest 40-60% of bathroom remodels uncover unforeseen conditions that add 3-10 days to the timeline. We'll communicate any findings immediately and provide options before proceeding.

Days 3-7: Rough-In (Plumbing, Electrical, Framing)

Rough-in is where the behind-the-wall work happens. New plumbing supply lines and drain pipes are installed or relocated. Electrical wiring goes in for lighting, exhaust fan, outlets, and any heated flooring. If walls are being moved or a niche is being added, framing happens now.

  • Plumbing rough-in: 1-3 days depending on whether pipes are being relocated or just replaced in place.
  • Electrical rough-in: 1-3 days for new circuits, GFCI outlets, lighting, and exhaust fan wiring.
  • Framing and backing: 1-2 days for structural changes, shower niche framing, and blocking for grab bars or heavy fixtures.

Rough-in work requires inspection before we can close up the walls. We schedule city or county inspectors during this phase — that inspection typically takes 1-3 days to get on the calendar.

Days 8-12: Waterproofing, Backer Board, and Shower Pan

After rough-in passes inspection, cement backer board goes up on shower walls and any areas that will receive tile. The shower pan or curbless shower base gets built and waterproofed. This is critical work — a poorly waterproofed shower will cause water damage within months. We apply waterproofing membrane and allow proper cure time (typically 24-48 hours) before tiling.

Days 13-20: Tile Installation

Tile work is usually the longest single trade phase in a bathroom remodel, taking 2-7 days depending on the complexity of the design. Shower wall and floor tile, bathroom floor tile, and any accent features like niches or decorative borders all happen now. After tile is set, grout goes in and needs 24-48 hours to cure before the shower can be used.

  • Shower wall tile: 2-4 days for a standard shower; longer for intricate patterns or large-format slabs.
  • Floor tile: 1-3 days depending on bathroom size and tile format.
  • Grout and cure time: 1-2 days. Rushing this step leads to cracking and staining.

Days 21-25: Fixture Installation

Now the bathroom starts looking like a bathroom. Vanity installation, countertop templating and installation (if stone), toilet, faucets, showerhead and valves, mirrors, lighting fixtures, towel bars, and accessories all go in. If you're getting a frameless glass shower door, it's measured after tile is complete and typically installed 5-10 business days later.

Days 26-30: Finishing and Punch List

Painting, trim work, caulking, final plumbing and electrical connections, and a thorough cleaning. We do a walkthrough with you to create a punch list of any items that need adjustment — a nick in the paint, a loose towel bar, caulk touch-ups. Most punch list items are resolved within 1-2 days.

For different shower design options that might affect your timeline, explore our guide to walk-in shower ideas for Sacramento homes.

How Long Do Sacramento Building Permits Take?

For 33% of homeowners, obtaining permits added an additional month to their renovation timeline (Clever Real Estate, 2024). Permit processing varies by jurisdiction, and in the Sacramento metro area you could be dealing with any of several different building departments depending on your location.

Sacramento County

Sacramento County plan review typically takes 15-45 days depending on project type and complexity. The City of Sacramento has a dedicated residential bathroom remodel permit category for non-structural projects, which can streamline the process. Simple permit applications (no structural changes, no plumbing relocation) can sometimes be processed same-day or within a few days through counter review.

Placer County (Roseville, Rocklin, Lincoln, Granite Bay)

Placer County residential plan review should not take more than 8 weeks for residential projects with a complete application. In practice, most bathroom remodel permits in our experience are processed in 2-4 weeks. Roseville has its own building department separate from the county, and they're generally efficient for residential bathroom work.

California AB 2234: Your Timeline Protection

Here's something most homeowners don't know: California Assembly Bill 2234 (effective January 1, 2023) requires building departments to return comprehensive revision requests within 30 business days for projects of 25 units or fewer. This state law puts a cap on how long the permit review process can drag on. If your local building department is slow, this law is your backstop.

We handle all permit applications and inspections as part of our remodeling service. Our familiarity with local building departments in Roseville, Rocklin, Folsom, Granite Bay, and Sacramento helps us submit complete applications that move through review faster.

What Causes Bathroom Remodel Delays?

According to a national survey, 41% of homeowners experienced significant delays in their last renovation (Clever Real Estate, 2024). Understanding the most common causes helps you avoid them.

Hidden Damage Behind Walls

This is the most common delay we encounter in Sacramento-area homes. Water damage from old shower pans, corroded galvanized pipes in pre-1990s homes, outdated wiring that doesn't meet current code, and subfloor rot under old tub installations. You can't see these problems until demo starts. We budget extra time in our schedules for the possibility, and our fixed-price proposals account for common hidden conditions.

Material Delays and Backorders

Custom vanities need 6-12 weeks. Specialty tile can take 3-6 weeks if it's imported or made-to-order. Even in-stock items can go on backorder without warning. The best prevention: finalize all material selections before construction starts, order everything with lead time buffer, and have backup options identified for critical items.

Change Orders

Industry data suggests change orders occur in 50-70% of remodeling projects, each adding 2-7 days to the timeline. A change order is any modification to the original scope — upgrading tile, moving a fixture, adding a heated floor. They're not inherently bad, but each one requires repricing, potential reordering, and schedule adjustment. The more decisions you lock in before construction, the fewer delays you'll have during construction.

Contractor Availability and Labor Shortages

The construction industry faces a 439,000-worker shortage nationally in 2025, with 499,000 forecasted for 2026 (Associated Builders and Contractors). In California specifically, electricians, plumbers, and low-voltage specialists are the three highest-demand trades. This shortage means contractors are booking further out, and subcontractor scheduling requires more advance planning than it did even two years ago.

If you're planning a remodel for summer 2026, don't wait until May to start calling contractors. Book early. Get on schedules. Our guide on choosing a bathroom remodel contractor in Roseville covers how to vet and select the right team.

Inspection Scheduling

After rough-in plumbing and electrical work, you need city or county inspections before walls can be closed up. Inspector availability varies — during peak season, it can take 3-5 business days to get an inspection scheduled. A failed inspection means rework and rescheduling. We build inspection wait times into our project schedules so they don't become surprises.

How Does the Time of Year Affect Your Remodel Timeline?

Sacramento area ranch home with contractor van and permit placard ready for bathroom remodel construction start

Three in four homeowners decide on a master bathroom remodel in the first half of the year, with January and February being particularly popular decision months (HIRI, 2024). About 30% of projects commence in early summer, with the majority completed by July or August. That seasonal pattern creates predictable demand waves.

Peak Season: May Through September

Sacramento's dry summers make this the most popular remodeling season. Contractors are at their busiest, lead times are longest, and you'll need to book further in advance. The upside: warm weather means open windows and faster drying times for tile, paint, and waterproofing materials. The downside: longer wait to get on the schedule.

Off-Peak Season: October Through February

This is the sweet spot for savvy Sacramento homeowners. Contractors have more availability, scheduling is more flexible, and material suppliers are less backed up. Since bathroom remodels happen entirely indoors, Sacramento's rainy season doesn't affect the work. You might also find better pricing from contractors filling winter schedules.

Our Recommendation

Start your planning in fall or early winter. Get design finalized, materials ordered, and permits submitted during the slower months. Schedule construction for late winter or early spring. You'll get better contractor availability and have your new bathroom ready before summer entertaining season.

Can You Live in Your Home During a Bathroom Remodel?

Yes — and most of our clients do. But it requires planning, especially if you're remodeling your only bathroom.

If You Have Multiple Bathrooms

This is straightforward. We close off the remodel area with plastic barriers and HEPA filtration, and you use your other bathroom during construction. You'll hear construction noise during work hours, but it's very manageable.

If You Have Only One Bathroom

This requires more coordination. Some options we've used with Sacramento-area clients:

  • Portable restroom: We can arrange a clean, private portable unit placed in your driveway. Not glamorous, but practical for 3-5 weeks.
  • Gym or community facility: Many clients with gym memberships use their facilities for showering during the remodel. Sacramento has several 24-hour gyms that make this convenient.
  • Stage the work: For larger projects, we can sometimes phase the work to keep the toilet functional for portions of the remodel, reducing the time you're fully without a bathroom.
  • Short-term stay: For full gut renovations lasting 8+ weeks, some clients stay with family or rent a short-term place for the most disruptive phase.

We discuss living arrangements during the planning phase so you're fully prepared before demo day. For ADA and accessibility remodels where the bathroom is critical for daily safety, we prioritize scheduling to minimize downtime. See our ADA bathroom remodeling guide for more on accessibility project planning.

How to Keep Your Bathroom Remodel on Schedule

Completed bathroom remodel in Sacramento area home with modern gray tile shower frameless glass and floating vanity

After 358+ projects, we've identified the habits that consistently separate on-time projects from delayed ones. Here's what actually works.

  1. Finalize all design decisions before construction starts. Every tile, fixture, paint color, and hardware piece should be selected, confirmed, and ordered. Mid-project changes are the number-one controllable cause of delays.
  2. Order materials with lead time buffer. If your custom vanity has a 10-week lead time, order it 12 weeks before you need it. Delays happen — build a cushion into your material timeline.
  3. Get permits submitted early. Don't wait until you're ready to start construction to apply for permits. Submit during the design phase so approval comes through before your scheduled start date.
  4. Be responsive to contractor questions. During construction, questions come up. A quick decision on your part keeps the crew moving. Delayed responses mean idle work.
  5. Avoid scope creep. It's tempting to add heated floors, a second shower niche, or an upgraded fixture mid-project. Each addition affects the timeline and budget. If you want to add scope, understand the time and cost impact before committing.
  6. Choose a contractor with in-house crews. Contractors who subcontract every trade have less scheduling control. Our in-house team means we control the calendar and don't depend on subcontractor availability for core work.
  7. Plan for the unexpected. Budget an extra week in your mental timeline for surprises. If everything goes perfectly, you finish early. If there's hidden water damage or a material delay, you've got breathing room.

Use our bathroom remodel cost calculator to build a realistic budget that accounts for timeline-related costs like temporary living arrangements or expedited shipping.

Tub-to-Shower Conversions: A Faster Timeline

If you want a new bathroom without the 5-8 week timeline, a tub-to-shower conversion is the fastest full-impact renovation we offer. Most conversions take just 1-2 weeks of construction.

The scope is focused: remove the tub, install a walk-in shower or curbless shower in the same footprint, tile the walls and floor, install glass door and fixtures. No plumbing relocation, no layout changes, no major structural work. It's a contained project with a predictable timeline.

In Sacramento, tub-to-shower conversions typically run $8,000-$15,000 depending on materials and shower size. For the full breakdown, read our guide on tub-to-shower conversion costs and timelines in California.

Pros

  • Predictable Schedule with Experienced Contractors: A contractor who's done hundreds of bathroom remodels in your area knows exactly how long each phase takes and builds realistic schedules from day one.
  • Fixed-Price Proposals Prevent Budget-Driven Delays: When costs are locked in upfront, you don't face mid-project sticker shock that causes delays while you deliberate on whether to proceed.
  • Indoor Project Unaffected by Weather: Unlike roofing, siding, or exterior work, bathroom remodels happen entirely inside. Sacramento's rainy winters don't affect your construction schedule.
  • Phased Approach Maintains Livability: With proper planning, you can live in your home throughout the remodel — even if it's your only bathroom.
  • Pre-Ordered Materials Eliminate Wait Time: When materials are selected and ordered during the design phase, they arrive before construction begins, keeping crews productive every day.
  • Local Permit Knowledge Speeds Approvals: Contractors familiar with Roseville, Placer County, and Sacramento building departments know how to submit complete applications that move through review faster.

Cons

  • Hidden Damage Extends Timelines: Water damage, outdated wiring, or corroded pipes discovered during demo can add 3-10 days to any remodel — and you won't know until walls are opened.
  • Custom Materials Require Long Lead Times: Custom vanities need 6-12 weeks of fabrication time. If you have your heart set on a specific piece, your total project timeline extends accordingly.
  • Peak Season Means Longer Waits: Booking a remodel during Sacramento's busy May-September season means waiting longer to get on the schedule and competing for subcontractor availability.
  • One-Bathroom Homes Face Inconvenience: If you only have one bathroom, you'll need alternative arrangements for 3-8 weeks. This requires advance planning and some lifestyle adjustment.
  • Permit Processing Is Unpredictable: While California law caps review times, actual processing varies by jurisdiction and application completeness. Budget 2-6 weeks for Sacramento-area permits.
  • Change Orders Add Up Quickly: Each mid-project change adds 2-7 days. Multiple changes can turn a 5-week project into an 8-week project.

Frequently Asked Questions

Most bathroom remodels in the Sacramento area take 3-8 weeks of active construction. A guest bathroom typically takes 3-5 weeks, while a master bathroom remodel runs 5-8 weeks. Full gut renovations can extend to 8-14 weeks. Add 4-12 weeks for pre-construction planning, material ordering, and permits, and the total project timeline is typically 2-5 months.

In most cases, yes. Any work that involves plumbing changes, electrical modifications, or structural alterations requires a building permit in Sacramento and Placer counties. Cosmetic updates like painting, replacing a vanity with same-location plumbing, or swapping fixtures may not require a permit. Your contractor should handle permit applications and inspections as part of the project. The City of Sacramento has a dedicated residential bathroom remodel permit category that can streamline the process for qualifying projects.

A tub-to-shower conversion is the fastest full-impact bathroom renovation, typically completing in 1-2 weeks of construction. It replaces your existing tub with a walk-in shower in the same footprint, so there's no plumbing relocation or layout changes needed. A half-bath refresh (vanity, mirror, lighting, paint) can also be completed in 1-2 weeks.

Not during active construction on that bathroom. Your toilet, shower, and sink will all be disconnected or removed during various phases. If you have a second bathroom, you'll use that one during the project. If you have only one bathroom, you'll need alternatives like a portable restroom, gym facilities for showering, or phased construction that keeps the toilet functional for portions of the project.

The three most common delay causes are: hidden damage discovered during demolition (water damage, outdated wiring, corroded pipes), material lead times for custom or specialty items (custom vanities can take 6-12 weeks), and mid-project change orders (each change adds 2-7 days). A 2024 survey found that 41% of homeowners experienced significant delays in their last renovation. The best prevention is thorough pre-construction planning and finalizing all design decisions before demo day.

The best time to start a bathroom remodel in Sacramento is during the off-peak season from October through February. Contractors have more availability, scheduling is more flexible, and you'll likely get onto the calendar faster. Since bathroom remodels happen entirely indoors, Sacramento's winter rain doesn't affect the work. Start planning in fall, order materials in winter, and schedule construction for late winter or early spring to have your new bathroom ready before summer.

Placer County residential plan review typically takes 2-8 weeks depending on project complexity and application completeness. The City of Roseville has its own building department separate from the county. California law AB 2234 requires building departments to return comprehensive revision requests within 30 business days for smaller projects, providing a legal timeline cap. Submitting a complete, accurate application is the best way to speed up the process.

Bathroom remodels in the Sacramento area range from about $8,000 for a basic tub-to-shower conversion to $75,000+ for a full master suite renovation. A guest bathroom remodel typically costs $12,000-$35,000, while a master bathroom remodel runs $25,000-$75,000 depending on scope, materials, and whether the layout is being changed. See our detailed Sacramento bathroom remodel cost guide for 2026 pricing breakdowns.

Myths & Misconceptions

Myth

A bathroom remodel should only take two weeks.

Fact

This misconception comes from home renovation TV shows that compress months of work into 30-minute episodes. In reality, most bathroom remodels take 3-8 weeks of active construction, and the total project timeline including planning and permits runs 2-5 months. A 2024 survey found that 54% of homeowners expected their renovation to take one month or less, but only 48% actually finished in that timeframe.

Myth

You don't need permits for a bathroom remodel since you're not adding square footage.

Fact

Permits aren't about square footage — they're about safety. Any plumbing changes, electrical modifications, or structural alterations require a permit in California. Working without permits means your work isn't inspected, which can hide dangerous conditions. It also creates problems when you sell your home — unpermitted work can delay or kill a sale. In Sacramento and Placer counties, most bathroom remodels that go beyond cosmetic updates require a permit.

Myth

Summer is the best time to remodel because contractors are busiest and most experienced crews are working.

Fact

Summer is actually the worst time if you want the best scheduling, pricing, and attention. Contractors are at peak demand, wait times are longest, and crews are stretched across multiple projects. The off-peak season (October-February) offers better contractor availability, more scheduling flexibility, and potentially better pricing. Since bathroom remodels are indoor projects, Sacramento's winter weather doesn't affect the work at all.

Summary

A Sacramento bathroom remodel typically takes 3-8 weeks of construction and 2-5 months total when you include planning, material ordering, and permits. The keys to staying on schedule are finalizing all design decisions before construction starts, ordering materials with lead time buffers, submitting permits early, and choosing a contractor who knows Sacramento-area building departments and can manage the entire process. Whether you're planning a quick tub-to-shower conversion or a full master suite renovation, realistic expectations and early planning will get you to a finished bathroom without the frustration that 58% of homeowners report feeling about their renovation timelines.

About Western Renovations

Western Renovations is a family-owned bathroom and kitchen remodeling company based in Roseville, California. With over 28 years of combined experience and 358+ completed projects, we specialize in shower installations, bathroom remodeling, ADA-accessible conversions, tub-to-shower conversions, kitchen remodeling, and ADU construction. We serve 15+ cities across the Sacramento metro area and maintain a 5.0-star Google rating. Contact us at (916) 200-9435 for a free estimate.
